Laydyne

Larkfield Electronics Plant 2

A two-storey electronics plant modelled from two drawing sheets: four SMT lines, test and packing upstairs, a parts warehouse and kitting downstairs, joined by AMRs and a goods lift.

No sign-in needed: open it in Studio, inspect the saved results and edit in 2D and 3D. Sign in to connect your own AI; project files remain free. Check Account for execution access. Opening asks before replacing your current space.

How many AMRs feed four SMT lines through one goods lift, and does moving kitting beside the lift or adding a second lift shorten line starvation?

Who uses it
Production engineers and equipment integrators
How it can create value
Size the AMR fleet and test a layout change before buying robots or cutting a second lift shaft.
Bring your site data
The floor plans, line takt and work times, kit lead times, AMR speed and the lift door and travel times.
Turn a comparison into a business decision →

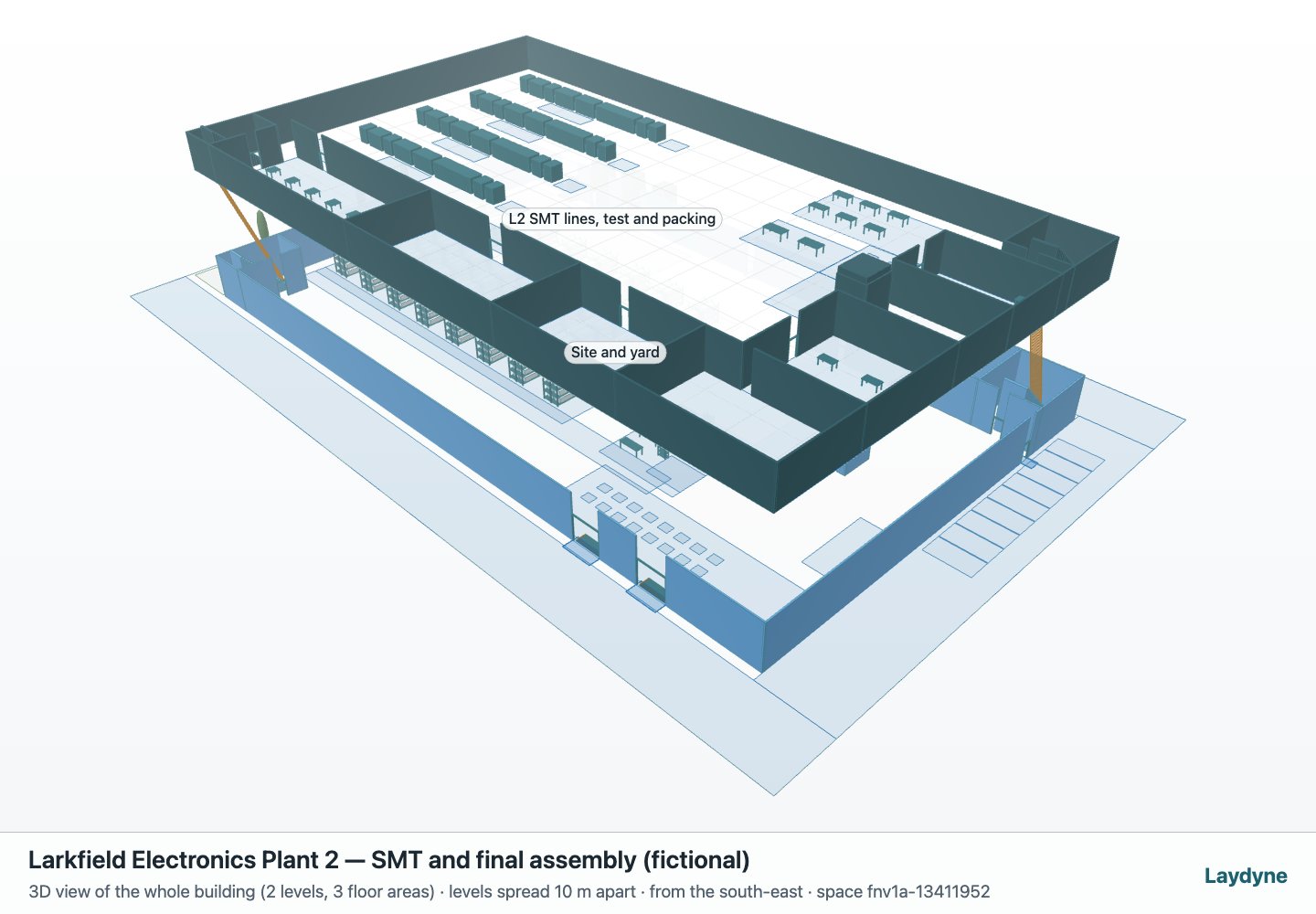

Actual Laydyne 3D model: Larkfield Electronics Plant 2

A model you can inspect.

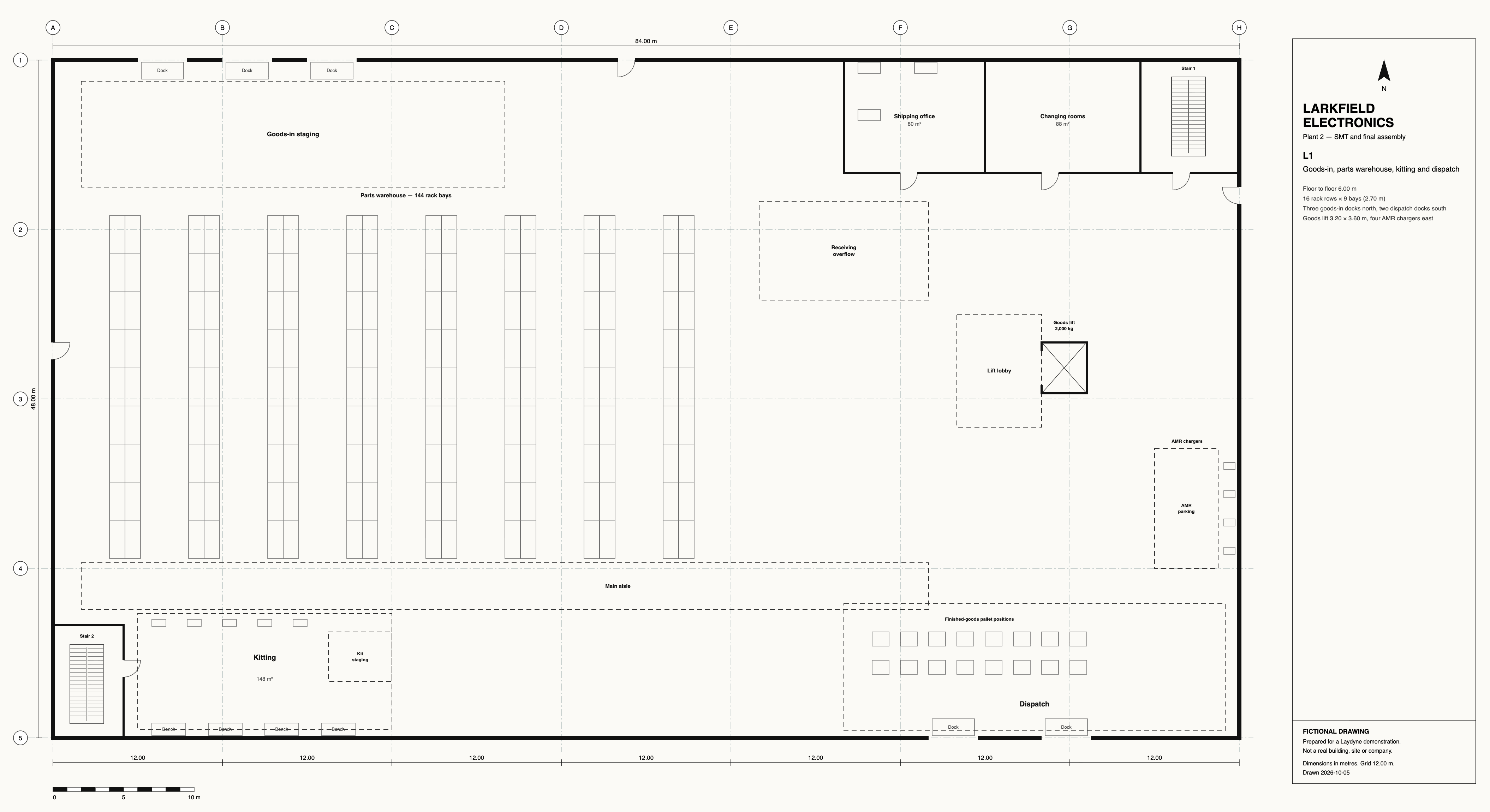

A fictional 84 × 48 m plant drawn as two sheets and modelled from them through HTTP MCP. L1 holds three goods-in docks, 144 rack bays, kitting, four AMR chargers and dispatch; L2 holds four SMT lines (loader, printer, SPI, two placers, reflow oven, AOI, unloader), six test benches, two packing benches and a pallet build area. One goods lift (one car, one AMR at a time) and two stairs join the floors. Lines break down now and then; six operators are shared between setup, test and packing.

Kit reorder → kitter picks from a rack bay → kit staging → AMR → goods lift → line-side kit drop; batch → SMT line → test → packing → pallet → AMR → dispatch

Compare an alternative

Compare kitting in the south-west corner as drawn against the same kitting furniture moved beside the lift lobby, with two AMRs and the same batch schedule.

Read the consequence

Read how often and how long a line waited for a kit, the AMR utilisation, the goods-lift wait and the batch lead time over the four-hour shift.

View the starting inputs
AMRs
2
Line operators
6
Minutes between batches per line
10

These dimensions are assumptions for the example.

Dimensions and quantities

SMT lines
4
Rack bays
144
Test and packing benches
6 + 2
Goods lift cars
1
Building floor area (m²)
8,064

These dimensions, arrivals and service times are synthetic assumptions. Replace them with site measurements before making an operational decision.

From two drawing sheets, through MCP

An AI agent drew two sheets for a fictional plant, laid them under the floors, traced them, built and checked the model, ran the day shift and compared three layouts of the kitting area and the goods lift, all with ordinary MCP tool calls.

StepMCP tools
Two sheets drawn, a fresh project with the site and two empty floors, and the sheets laid under their floors, scaled and tracedcreate_space · apply_changes · set_underlay · trace_underlay
415 parts and 11 connections on three floors, built from the traces; the sheets corrected and traced againapply_changes · set_underlay · trace_underlay
All floors checked and measured against the sheets: 0 issues, median 1.5 mm on L1 and 3.5 mm on L2check_space · measure_underlay_fit · get_view_image
The day shift run and option A saved; the AMR count swept from 1 to 3; kitting moved beside the lift (C) and a second lift added (B), each saved, swept and comparedrun_process_scenario · save_process_option · sweep_process_parameters · edit_space · edit_floors · compare_process_options
Option B redone with the car filling its shaft (0 issues), then A and B compared againedit_space · check_space · compare_process_options
The project exported, the public example registered and playback pictures takenexport_project · get_view_image · save_local_project

From the fresh project to the compared options the agent made 128 MCP calls, 126 of them successful; registering the public example took 41 calls. This edition adds detail to the original model: 694 parts, refined in code and verified through 61 MCP calls. The original saved options and results remain in the project.

Try it with your own AI

Download the sheets, connect your AI to Laydyne and ask it to model the building from them. The steps above record the original build; results depend on your AI.

The same demand. A different capacity.

Observation window 240 minutes. Means across 3 runs, seeds 11–13.

The candidate moves the four kitting benches, five shelves and the kit staging area from the south-west corner to the open floor beside the lift lobby. AMR trips get shorter and the kitters walk farther to the racks; AMR count, lift, lines and demand are unchanged.

ScenarioCompletedMean wait
Baseline
Kitting south-west · 2 AMRs
150 / 18617m 20s
Candidate
Kitting beside the lift · 2 AMRs
183.7 / 18611m 10s

Synthetic calculations, not measurements of an operating facility. Waiting averages include unfinished waits. Collisions, crowd safety and temperature are not simulated.

Engine, status and output notes

process-des-2.7.0. Status: Baseline: horizon_reached; Candidate: horizon_reached

Engine inputs and saved comparisons stay with the saved project. Any limited trace affects playback details, not aggregate metrics.
