Laydyne

Assembly line kanban

Line 2 moves to a 60 s takt. Can one water spider still keep four stations supplied, or do they stand starved waiting for bins?

No sign-in needed: open it in Studio, inspect the saved results and edit in 2D and 3D. Sign in to connect your own AI; project files remain free. Check Account for execution access. Opening asks before replacing your current space.

Before Line 2 moves to a 60 s takt: can one water spider keep the stations supplied, or do we add a second, more kanban cards or a faster supermarket pick?

Who uses it
Production engineers, line supervisors and lean and logistics planners
How it can create value
See whether stations starve for want of stock at the line or of the water spider’s time before hiring, buying racks or reorganising the supermarket. Here the spider is the bottleneck: more cards only delay the stops, a second person or a 25 s pick removes them. A shorter run saves money only if overtime or staffing actually fall; weigh the line-side space and stock of extra cards and the cost of a second spider against measured times.
Bring your site data
The takt and shift plan, parts per unit and bin quantities for every part, a time study of the water spider (collecting cards, picking and setting in bins), the route on your floor plan, station cycle times, rework rates and pallet quantities. One trip per card and all times here are assumptions.
Turn a comparison into a business decision →

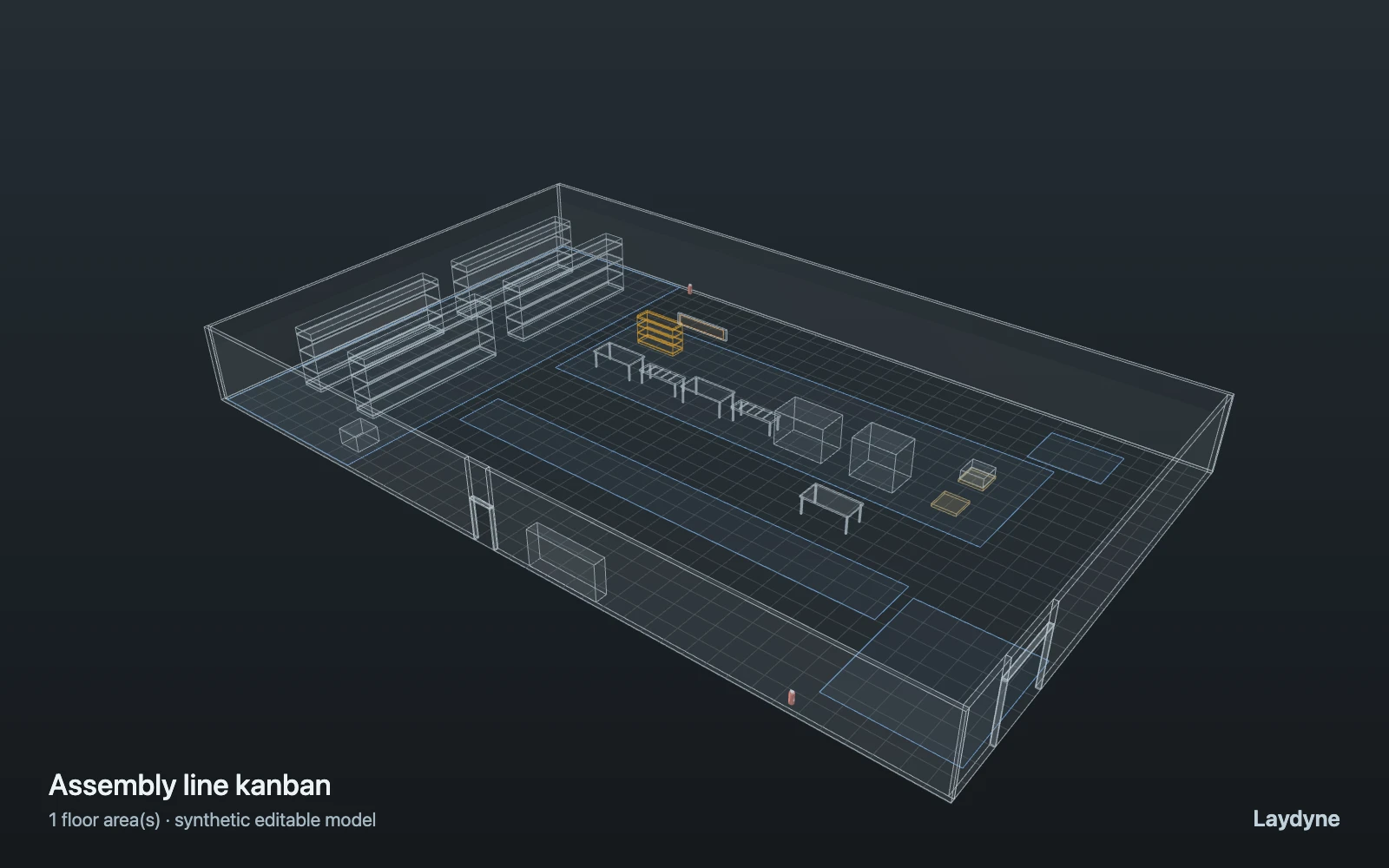

Actual Laydyne 3D model: Assembly line kanban
Assembly line kanban1 level · 374 parts · synthetic layout

A model you can inspect.

Line 2 at its new 60 s takt: 120 units pass four stations (42–66 s each) joined by roller buffer conveyors of 2, then inspection (40 s); 10 % are reworked (2–5 min) and inspected again. Each station takes its parts from the kanban flow rack behind it, two bins a part (brackets 12, harnesses 6, M5 screws 48, covers 6; a unit takes 2, 1, 8 and 1). An emptied bin sends its card to the kanban post and the water spider on a trip: collect the card (5 s), pick a full bin in the supermarket (45 s), set it into the rack (20 s), walk back to the base at 1 m/s. A station whose rack is empty stands starved, holding its unit, until the bin arrives; every 4 good units make a pallet the forklift takes to shipping. Each card is its own trip (no collecting several on one loop); no breakdowns, breaks, congestion in the aisles or costs. Figures are assumptions, not measured.

Station 1 (2 brackets) → buffer → station 2 (a harness) → buffer → station 3 (8 screws) → buffer → station 4 (a cover) → inspection → rework and re-inspection for 10 % → pallet of 4 → forklift to shipping. Each emptied bin sends a kanban card: the water spider collects it at the kanban post, picks a full bin in the supermarket and sets it into the station’s flow rack.

Change one thing

Compare 1 water spider with 2, with a third kanban card for every part and with a 25 s pick in the supermarket, on the same 120 units; then try buffers of 1 or 4, a 65 s takt or 15 % rework.

Read the consequence

Stations turning red while their rack is empty, units queuing at the line head, the water spider’s utilization and when the last pallet ships. With one spider the stations stand starved for about an hour in all and the run ends 27 minutes later; a second spider or a 25 s pick removes the stops; a third card cuts them by about 40 % but finishes no sooner, because the spider stays the bottleneck.

View the starting inputs
Takt: a unit started every (s)
60
Units in the shift
120
Water spiders on the milk run
1
Kanban cards (bins) for each part
2
Picking a bin in the supermarket (s)
45
Units a buffer conveyor holds
2
Units failing inspection (%)
10

Agent counts, routes and resource definitions are also saved in the project JSON.

The same demand. A different capacity.

Means across 3 runs, seeds 11–13. Observation window 180 minutes. Arrivals, geometry and the seed set stay the same in every option.

ScenarioCompletedMean waitMean cycleBlocked
1 water spider · 2 cards2306m 43s10m 05s0
2 water spiders · 2 cards23052s4m 14s0
1 water spider · 3 cards2304m 21s7m 42s0
1 water spider · 25 s pick2301m 09s4m 24s0

Waiting averages cover arrived jobs, including unfinished waits; cycle averages cover completed jobs only. These are synthetic calculations, not measured site performance, revenue or a safety assessment.

Engine, status and output notes

process-des-2.7.0. Status: 1 water spider · 2 cards: completed; 2 water spiders · 2 cards: completed; 1 water spider · 3 cards: completed; 1 water spider · 25 s pick: completed. “Completed” is the engine run status, not success for every job. Check blocked jobs and warnings.

  • No engine warnings.

Engine inputs and saved comparisons stay with the saved project. Any limited trace affects playback details, not aggregate metrics.
